Detached garage ADU vs new construction ADU comparison in a South Bay backyard

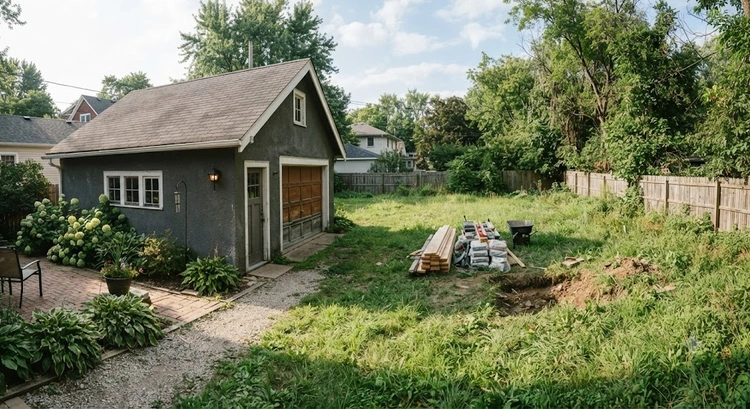

Figure 1 — A converted detached garage sits beside foundation work for a ground-up backyard cottage.

Converting an existing detached garage into an ADU costs, on average, 40 to 60 percent less per square foot than pouring a new foundation for a ground-up backyard cottage, based on permit and bid data our team has tracked across Santa Clara County. That gap sits at the center of the detached garage ADU vs new construction ADU decision facing most South Bay homeowners, and it drives nearly every conversation we have during initial detached garage conversion consultations. Structural shell, roof, and slab already exist in a garage conversion, which removes the single largest cost and schedule variable in any backyard housing project.

Our team has walked both paths with clients across San Jose, Sunnyvale, and Santa Clara, and the tradeoffs rarely come down to cost alone. Site constraints, existing garage condition, and long-term use of the space all factor into which route makes sense. This piece breaks down what we have observed on real projects, where each approach wins, and how homeowners can weigh the decision before committing to a design.

Detached Garage ADU vs New Construction ADU: What the Data Shows

Our team has priced both scenarios side by side for the same lot dozens of times, and the pattern holds consistently. A 400 to 600 square foot detached garage conversion typically finishes in the mid-to-high five figures, while a ground-up cottage of the same footprint often lands well into six figures once foundation, framing, and roofing are included from scratch. The gap widens further when a garage already has adequate ceiling height and a slab in serviceable condition, since demolition and re-pour costs disappear entirely.

Two South Bay Projects, Two Different Paths

One recent San Jose client converted a detached two-car garage into a one-bedroom ADU in just under five months, reusing the existing slab after a structural engineer confirmed it met current load requirements. A second client on the same street opted for new construction after their garage sat on a cracked, undersized foundation that could not be economically repaired. That project took closer to nine months and required a full new foundation build-out before framing could begin.

Pro insight from our team: never assume an existing garage slab is usable. A geotechnical or structural evaluation before design work begins prevents costly surprises mid-permit.

What the Numbers Show On-Site

Across the projects our team has completed, garage conversions average roughly 30 percent faster construction timelines than ground-up cottages of comparable size. Several factors explain this consistently:

  • Existing roof and wall framing eliminate weeks of structural work
  • Utility runs are often shorter since the garage already sits near the main panel
  • Fewer grading and drainage changes are required around an existing structure
  • Inspection cycles tend to move faster with less new structural scope

Planning Decisions That Save Time and Money

Regardless of which path a homeowner chooses, planning decisions made in the first few weeks determine most of the eventual cost and schedule outcome. Our team has found that early structural and utility assessments prevent the majority of change orders that inflate budgets mid-project.

Sequencing Permits and Utility Work

Electrical and plumbing scope should be finalized before submitting plans, since Title 24 energy compliance requirements shift significantly based on whether an existing structure is reused or replaced. Homeowners considering a full kitchen or expanded bathroom often benefit from reviewing utility separation early, and our team frequently points clients toward the discussion in what it actually costs to turn a detached garage into a guest house before finalizing scope. New construction projects carry more flexibility on utility placement but also more design decisions that can stall a permit review if left unresolved.

Common Missteps We See on Both Paths

Several recurring errors show up regardless of which approach a project takes:

  • Assuming an existing electrical panel has enough capacity without a load calculation
  • Underestimating setback and lot coverage limits specific to the jurisdiction
  • Delaying structural engineering review until after design is finalized
  • Skipping soil testing before committing to a foundation type for new builds

Our team addresses these issues during the earliest site visit, since catching them before design work begins avoids redesign fees later in the process.

Cost, Timeline, and Structural Tradeoffs at a Glance

The table below summarizes how the two approaches typically compare across the factors homeowners ask about most, based on averages from recently completed South Bay projects.

FactorDetached Garage ADUNew Construction ADU
Typical cost per square footLower, reuses existing shellHigher, full ground-up build
Average timeline4–6 months7–11 months
Foundation workOften reused after evaluationAlways required
Design flexibilityConstrained by existing footprintFully customizable layout
Permit complexityModerateHigher, more structural review

Foundation and Utility Considerations

Foundation condition remains the single biggest cost swing factor our team encounters. A slab that passes structural review saves tens of thousands of dollars, while one that fails requires the same excavation and pour work as a ground-up build. Utility separation, covered in depth in our overview of garage ADU utility separation, also tends to be simpler in a conversion since existing conduit and drain lines often need only extension rather than complete replacement.

Permitting Timelines Side by Side

Plan check duration differs less between the two approaches than most homeowners expect, since both require full structural, electrical, and Title 24 review in Santa Clara County jurisdictions. New construction plans typically take slightly longer to review due to added structural calculations for the foundation and shear wall design that a conversion project can often skip.

Matching the Project to Site Conditions and Complexity

Choosing between the two approaches ultimately depends on the physical condition of the existing garage and how much design flexibility a household actually needs. Our team walks every client through both scenarios before recommending one over the other.

Straightforward Conversions

Garages with sound foundations, adequate ceiling height, and reasonably close utility access are strong conversion candidates. These projects move faster, cost less, and generally involve fewer unknowns once demolition begins. Most single-story detached garages built within the last several decades fall into this category, according to structural assessments our team has conducted across the region.

Quick tip: garages with at least 9 feet of clear height to the roof framing generally avoid costly roof-raise work during conversion.

Complex Builds Requiring Specialized Trades

Garages with foundation cracking, inadequate setbacks, or significant grade changes across the lot often push a project toward new construction by necessity rather than preference. These builds require closer coordination between structural engineers, grading contractors, and electrical trades, and they benefit from the flexibility that a clean-sheet design provides. According to the Wikipedia entry on accessory dwelling units, jurisdictions nationwide have increasingly streamlined ADU permitting, which has made both conversion and new construction paths more viable than they were a decade ago.

Frequently Asked Questions

Is a detached garage ADU always cheaper than new construction?

In most cases yes, since the existing slab, walls, and roof reduce material and labor costs substantially, though a garage with a failed foundation can close that gap significantly.

How long does a detached garage ADU conversion typically take?

Our team generally sees four to six months from permit issuance to final inspection, compared with seven to eleven months for a comparable new construction ADU.

Can an existing garage foundation be reused for an ADU?

It depends on the slab's condition and load capacity, which a structural engineer should evaluate before design work begins, since reuse eligibility varies by garage age and construction quality.

Does new construction offer more design flexibility than a conversion?

Yes, a ground-up cottage allows full control over layout, window placement, and room dimensions, while a conversion is constrained by the existing garage footprint and structural elements.

Next Steps

  1. Schedule a structural evaluation of the existing garage slab and framing before committing to either approach
  2. Request a load calculation on the current electrical panel to determine whether an upgrade is needed
  3. Compare permit timelines with the local building department, since review speed varies by jurisdiction
  4. Review setback and lot coverage limits specific to the property before finalizing a design direction
  5. Get itemized bids for both a conversion and a new construction scenario to compare true costs side by side
