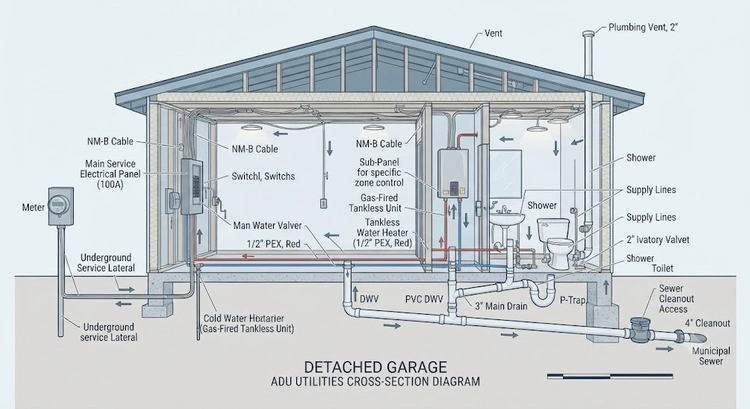

A typical detached garage ADU in Santa Clara County needs three separate utility trenches, one electrical, one water, one sewer, before a final inspection is even scheduled, and skipping the planning stage on any of them is the single fastest way to blow a construction timeline. Detached garage ADU utility hookups are rarely a simple extension cord and a garden hose; they involve new panel capacity, pressurized water lines rated for continuous fixture use, and a gravity-fed or ejector-pump sewer connection that must satisfy both the Uniform Plumbing Code and local backflow requirements. Contractors who treat these hookups as an afterthought end up trenching the same yard twice, which is expensive and entirely avoidable with early coordination.
Detached structures sit outside the existing envelope of the main house, which means every utility has to travel underground or, in rare cases, overhead, to reach the new living space. That distance dictates pipe sizing, conductor gauge, and slope requirements in ways an attached conversion never has to consider. The decision tree gets more complicated once a full bathroom, kitchen, or in-law suite enters the picture, since garage ADU utility separation choices made early determine whether the unit can be metered independently or must share service with the primary residence.
This guide walks through what South Bay homeowners and their contractors actually need to specify for electrical, plumbing, and sewer work before a permit application goes anywhere near the city counter.
Contents
Sizing Electrical Service for the Detached Unit
Panel Capacity and Subpanel Decisions
Most existing 100-amp main panels have little to no room left once a detached unit adds a kitchen, HVAC mini-split, and full bathroom load, so a load calculation should happen before anyone talks about wire gauge or conduit routing. A detached garage conversion often needs its own panel rather than a handful of new breakers squeezed into the existing box, and that decision alone reshapes the entire trenching plan. Subpanel sizing should account for continuous loads like water heating and space conditioning, not just lighting and receptacles.
Pro tip: size the subpanel for the largest plausible future load, not just today's appliance list, because upsizing a buried feeder later means re-trenching the entire yard.
- 200-amp main service is now the practical minimum for a detached unit with a full kitchen
- Dedicated 50-amp circuits should be reserved for range and dryer loads even if gas appliances are planned initially
- EV charging capacity is worth roughing in now, since retrofitting a driveway trench later costs far more
Conductor Runs and Trenching Depth

Underground feeder cable buried without conduit needs a minimum 24-inch burial depth under most local amendments, while conduit-protected runs can sometimes go shallower, and getting this wrong is a guaranteed red tag at rough-in inspection. Conductor gauge has to account for voltage drop over distance, which matters more on detached structures than attached ones because the run is almost always longer than 50 feet. Coordinating this trench with the water and sewer lines in a single dig session saves labor and restores the yard once instead of three separate times.
Plumbing Supply Lines and Fixture Demand
Pipe Sizing and Pressure Loss
A 3/4-inch supply line handles most single-bathroom detached units comfortably, but adding a kitchen sink, dishwasher, and washing machine to the same branch usually pushes the requirement to a full 1-inch trunk line to avoid pressure complaints at peak fixture demand. Distance from the main shutoff compounds pressure loss the same way it compounds voltage drop on the electrical side, so the plumbing rough-in plan should be modeled against actual fixture unit counts rather than guesswork.
| Fixture Load Scenario | Minimum Supply Line | Typical Water Heater |
|---|---|---|
| Half bath only (JADU) | 1/2 inch branch | Point-of-use tankless |
| Full bath + kitchenette | 3/4 inch branch | Compact tankless or 20-gal electric |
| Full bath + kitchen + laundry | 1 inch trunk line | Tankless gas or dedicated 40-gal tank |
None of these figures replace an actual fixture unit calculation, but they reflect what most South Bay detached units end up needing once the design settles.
Water Heating Location
Point-of-use tankless units mounted inside the detached structure eliminate long hot-water supply runs and the standby heat loss that comes with them, which matters enormously on a small footprint where every wasted BTU shows up on a utility bill. Locating the water heater inside the ADU envelope also simplifies the plumbing rough-in inspection, since it removes one more buried line from the yard.
Sewer and Drainage Tie-In Strategy
Gravity Flow Versus Ejector Pumps
Gravity drainage only works when the detached unit's floor elevation sits high enough above the existing sewer lateral to maintain the required 1/4-inch-per-foot slope, and on many South Bay lots that math simply does not work without excavation nobody budgeted for. When gravity flow is not achievable, a sewage ejector pump becomes the practical answer, and that decision needs to happen at the design phase rather than after the slab is poured. The mechanics of a proper sewer line tie-in for a garage-to-ADU bathroom depend entirely on getting this elevation study right before permits are drawn.
Warning: never assume gravity flow is possible just because the garage looks level with the house; have the invert elevations surveyed before finalizing the bathroom layout.
Backflow and Backwater Protection
Any fixture installed below the rim elevation of the nearest upstream manhole needs backflow protection, and most detached garage conversions with a lowered slab or below-grade bathroom fall squarely into that category. Whether a backwater valve is required for a garage conversion bathroom depends on that elevation relationship, not on personal preference, and inspectors will check it against as-built drawings. Skipping this step is one of the most common reasons sewer rough-in fails on the first pass.
Permitting and Utility Coordination
Inspection Sequence for Rough-In Work
Electrical, plumbing, and sewer rough-ins each get their own inspection before the trench can legally be backfilled, and scheduling all three inspectors for the same week keeps the yard open the shortest possible time. Cities differ on how strictly they enforce open-trench timelines, but leaving a live trench unattended for weeks invites both erosion issues and neighbor complaints.
- Electrical rough-in inspection: conduit, conductor size, and grounding verified before cover
- Plumbing rough-in inspection: pipe material, slope, and cleanout placement verified
- Sewer lateral inspection: often requires a separate city inspector distinct from the plumbing inspector
Working With the Utility Company
Independent metering for a detached unit requires utility company sign-off long before the electrical rough-in inspection, and that application process can take longer than the actual trenching work. Anyone planning full electrical, plumbing, and HVAC rough-in for a detached structure should submit the utility service application in parallel with the building permit rather than sequentially, since waiting for one before starting the other adds weeks to the schedule for no good reason.
Cost Drivers and Common Pitfalls
Hidden Costs in Trenching
Concrete and hardscape removal along the trench path routinely doubles the labor cost of what looks like a simple utility run on paper, and homeowners rarely budget for it until the estimate arrives. Rock, tree roots, and existing irrigation lines add unplanned hours that a fixed-bid contractor either eats or passes along, so a site survey before bidding saves both parties from an ugly change order mid-project. According to the EPA's WaterSense program, efficient fixture selection at the plumbing design stage also reduces long-term water demand on a property, which matters more on a unit with its own meter.
Sequencing Mistakes That Delay Inspections
Pouring a slab before the sewer invert elevation is confirmed is the single most expensive mistake seen on detached ADU projects, because correcting it means jackhammering concrete that was poured too soon. Trenches dug without a joint electrical-plumbing-sewer plan also tend to cross each other at the wrong depths, which inspectors flag immediately and which forces rework nobody priced into the original bid.
Insider note: the cheapest change in this entire process is moving a fixture six inches during design; the most expensive is moving a slab after it cures.
Real-World Configurations by Project Type
JADU With Shared Service
A junior ADU sharing the main house's electrical service and water meter keeps utility costs low and simplifies permitting considerably, since no new utility account or independent metering application is needed. This configuration works best for smaller units without a full kitchen, where a detached garage ADU compared against a new backyard cottage often comes down to exactly this kind of utility simplicity.
Full ADU With Independent Metering
A full detached ADU intended for long-term rental almost always benefits from independent electrical metering, even though it costs more upfront, because it separates utility billing cleanly between the main house and the rental unit. Sewer and water typically remain on a shared lateral back to the street, since separate laterals rarely make financial sense for a single-lot property.
Frequently Asked Questions
Does a detached garage ADU always need its own electrical panel?
Not always, but any unit with a full kitchen, HVAC, and bathroom typically exceeds what an existing 100-amp panel can support, making a dedicated subpanel the practical choice in most South Bay projects.
Can a detached garage ADU share the house's sewer line?
Yes, most detached units tie into the existing sewer lateral rather than running a new line to the street, provided the elevation and slope requirements can be met.
Why does trenching cost more than expected on these projects?
Hardscape removal, unexpected rock or roots, and existing irrigation lines routinely add labor hours that a paper estimate can't account for until the site is actually opened up.
Final Thoughts
Detached garage ADU utility hookups reward homeowners who plan electrical, plumbing, and sewer work as one coordinated trenching project rather than three separate afterthoughts. Anyone starting design on a detached unit should get a site survey and elevation study scheduled before finalizing the floor plan, since that single step prevents the most expensive mistakes on this list.
