San Jose's Building Division processed more than 1,400 accessory dwelling unit (ADU) applications last year, and internal review logs show the typical garage conversion moves from first submittal to final sign-off in roughly 90 to 180 days. For homeowners weighing a garage-to-ADU project, the San Jose ADU permit timeline is often the single biggest unknown in the entire process, shaping contractor scheduling, financing plans, and eventual move-in dates. A closer look at how the city's review teams handle these applications, building on patterns documented in how long a garage conversion permit typically takes in San Jose, helps set realistic expectations before a single wall gets framed.

Garage conversions differ from ground-up construction because an existing structure, foundation, and roofline are already in place, which can shorten some review steps. That said, plan reviewers still evaluate structural framing, electrical and plumbing rough-in, and energy compliance exactly as they would for new construction. Most delays trace back to incomplete drawings, missed Title 24 (California's building energy efficiency code) documentation, or slow responses to correction letters rather than the city's baseline processing speed.

San Jose ADU permit timeline shown through blueprints and a garage conversion in progress
Figure 1 — A garage conversion project moving through San Jose's permit review stages.

This guide breaks the process into its component stages, shows sample timelines from real South Bay projects, and outlines the documentation that tends to keep applications moving. It also flags the mistakes that most often add weeks to an otherwise straightforward review.

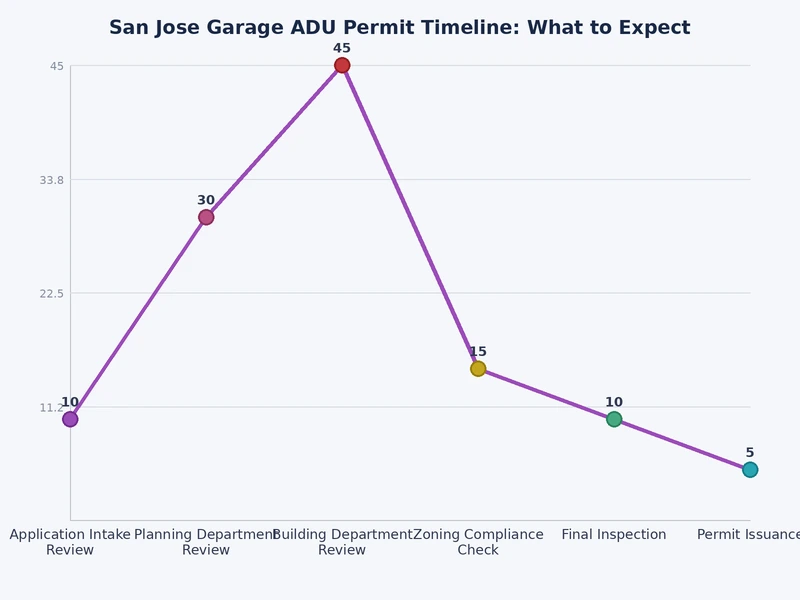

Bar chart showing average days spent in each stage of the San Jose ADU permit timeline
Figure 2 — Average time spent in each stage of the review process, based on recent South Bay garage conversion cases.

Understanding the San Jose ADU Permit Timeline

State law requires cities to act on complete ADU applications within 60 days, but that clock only covers the initial plan check decision, not the full path to a finished, inspected unit. The complete San Jose ADU permit timeline includes pre-submittal design work, plan review rounds, permit issuance, construction, and a series of inspections before final approval.

Plan Check Versus Permit Issuance

Plan check refers to the city's review of construction drawings for code compliance, while permit issuance is the point at which fees are paid and construction can legally begin. These are separate milestones, and homeowners sometimes assume a project is "approved" once plan check clears, when in fact issuance and inspections still lie ahead.

  • Plan check: typically 4 to 8 weeks for a first review cycle
  • Correction response and resubmittal: 1 to 3 weeks per round, depending on how quickly revisions are returned
  • Permit issuance: usually within days once corrections are cleared and fees are paid
  • Construction and inspections: 8 to 16 weeks depending on scope

Factors That Affect Duration

Several variables push a project toward the shorter or longer end of the range, and most of them are within a homeowner's control.

  • Whether the garage is attached or detached from the main house
  • How many rough-in trades are involved, such as electrical, plumbing, and HVAC (heating, ventilation, and air conditioning)
  • The completeness of Title 24 energy documentation submitted with the initial package
  • How quickly a homeowner or contractor responds to correction letters
  • Current staffing and application volume at the Building Division
Pro tip: applications submitted with a complete Title 24 energy report on the first pass typically avoid an entire correction cycle, saving two to three weeks.

Required Documents and Pre-Submittal Prep

Most delays in the San Jose ADU permit timeline originate before the application is even filed, when drawings or supporting reports are incomplete. Reviewers cannot approve a package with missing information, so an incomplete submittal simply restarts the clock once resubmitted.

Design and Engineering Drawings

A complete drawing set generally includes floor plans, elevations, a site plan, structural details, and a Title 24 compliance summary. Garage conversions also require documentation showing how existing framing and foundation will support the new living space.

  • Existing and proposed floor plans, drawn to scale
  • Site plan showing setbacks and parking replacement, addressed further in how long a detached garage-to-ADU conversion takes
  • Structural calculations for any new openings or load changes
  • Electrical, plumbing, and mechanical rough-in layouts

Title 24 Energy Compliance Reports

Title 24 sets California's minimum standards for insulation, windows, and mechanical efficiency, and every converted garage must demonstrate compliance before permits are issued. Homeowners can review the city's full requirements on the permits and Title 24 energy compliance service page, which outlines what documentation reviewers expect.

According to the California Department of Housing and Community Development, ADU-specific streamlining rules apply statewide, though local jurisdictions like San Jose still enforce their own plan review and inspection procedures.

Step by Step: From Application to Final Inspection

The process follows a fairly consistent sequence across most South Bay cities, even though exact review times vary by workload and project complexity.

Submittal and Intake

  1. Compile the full drawing set, structural calculations, and Title 24 report
  2. Submit through the city's online permitting portal along with applicable fees
  3. Receive an intake confirmation and assigned plan check number, usually within a few business days

Plan Review and Corrections

  1. Building, electrical, plumbing, and mechanical reviewers each evaluate the drawings independently
  2. Corrections are compiled into a single letter listing every required change
  3. Revised drawings are resubmitted, and a second, typically shorter, review cycle follows
Warning: ignoring even one item on a correction letter can send an entire resubmittal back to the bottom of the review queue.

Inspections and Sign-Off

  1. Rough framing, electrical, and plumbing inspections occur as each phase of construction is completed
  2. Insulation and drywall inspections follow once rough-in passes are signed off
  3. A final inspection confirms the unit meets code before the certificate of occupancy is issued
Garage TypePlan CheckConstructionTotal Estimate
Attached Garage JADU4-6 weeks8-12 weeks3-4.5 months
Attached Garage ADU5-7 weeks10-14 weeks4-5 months
Detached Garage ADU6-8 weeks12-16 weeks4.5-6 months

Real Timelines From South Bay Garage Conversions

Actual case data illustrates how the general ranges above play out on real properties, where site conditions and homeowner responsiveness shape the final schedule.

Attached Garage JADU Example

A junior accessory dwelling unit (JADU), which shares at least one wall with the main house, was converted from an attached two-car garage in central San Jose. Plan check cleared in five weeks with one minor correction round, and construction, including fire-rated wall separation, wrapped in ten weeks, for a total of roughly fifteen weeks from submittal to final inspection.

Detached Garage ADU Example

A detached garage conversion in a nearby South Bay neighborhood required new sewer and electrical utility connections, which extended both plan check and construction. That project took seven weeks to clear plan review and fourteen weeks to build out, landing near the upper end of typical detached-garage timelines.

  • Attached conversions generally move faster because utility connections already exist
  • Detached conversions often need new trenching for sewer, water, or electrical service
  • Both project types benefit from submitting complete Title 24 documentation up front

Strategies to Avoid Delays

Most homeowners cannot change how many staff members review applications in a given month, but several factors within their control have an outsized effect on the overall San Jose ADU permit timeline.

Common Mistakes That Add Weeks

  • Submitting drawings without a complete Title 24 energy report
  • Underestimating parking replacement requirements tied to the garage conversion
  • Waiting several weeks to respond to a correction letter instead of turning it around quickly
  • Changing the scope of work mid-review, which can trigger a fresh evaluation

Ways to Speed Up Approval

  1. Work with a designer familiar with San Jose's specific ADU checklist before submittal
  2. Bundle electrical, plumbing, and mechanical rough-in details into one coordinated package
  3. Respond to correction letters within a few days rather than weeks
  4. Schedule inspections promptly as each construction phase wraps up
Pro insight: a brief pre-application meeting with city staff can surface site-specific issues, such as setback conflicts, well before formal submittal.

Frequently Asked Questions

How long does the San Jose ADU permit timeline typically take from start to finish?

Most garage conversions move from submittal to final inspection in three to six months, depending on garage type and how quickly corrections are addressed.

Does state law guarantee a 60-day approval?

State law requires a decision on a complete ADU application within 60 days, but that covers plan check only, not construction and inspections that follow.

Is a detached garage conversion slower than an attached one?

Generally yes, because detached garages often need new utility connections for sewer, water, or electrical service that attached conversions already have.

What is the biggest cause of permit delays?

Incomplete Title 24 energy documentation and slow responses to correction letters are the most common causes of extended review times.

Can a pre-application meeting shorten the process?

Yes, a short meeting with city staff before formal submittal can identify site-specific issues early, reducing the chance of a lengthy correction cycle.

Do JADUs and ADUs follow the same review process?

They follow a similar plan check and inspection sequence, though JADUs are generally smaller in scope and can clear review slightly faster.

Where can homeowners check current permit status?

San Jose's online permitting portal allows applicants to track plan check status and view any outstanding correction items in real time.

Key Takeaways

  • The full San Jose ADU permit timeline generally runs three to six months from submittal to final inspection, though the state's 60-day rule covers plan check only.
  • Complete Title 24 energy documentation and thorough drawings at first submittal are the single biggest factors in avoiding delays.
  • Detached garage conversions typically take longer than attached ones due to new utility connections for sewer, water, and electrical service.
  • Responding quickly to correction letters and scheduling inspections promptly can shave weeks off the overall process.
