The subpanel upgrade cost for a garage ADU in the South Bay typically runs between $2,200 and $6,500, depending on amperage, panel location, and whether the main service also needs a bump. Most conversions covered under a garage-to-ADU conversion scope require this work because a legacy garage circuit was never designed to carry a kitchen, bathroom, and HVAC load simultaneously. Understanding where that number comes from, and what pushes it higher, helps homeowners budget accurately before permits are even submitted.
Garage conversions occupy a strange middle ground in residential electrical work. The original structure often has a single 15- or 20-amp circuit intended for a garage door opener, a few outlets, and perhaps a shop light. Converting that space into a legal dwelling unit changes the calculus entirely, since code now treats it as a habitable structure with its own demand for lighting, appliances, and mechanical equipment. Municipal building departments across the South Bay, including San Jose, Santa Clara, and Sunnyvale, apply California Title 24 and the California Electrical Code consistently, which means the subpanel question surfaces in nearly every project regardless of city.
This article breaks down the cost drivers, the equipment involved, the long-term planning considerations, and practical steps homeowners can take to avoid budget surprises mid-project.
Contents
- Why Garage ADUs Almost Always Need Electrical Upgrades
- Subpanel Upgrade Cost for a Garage ADU, Line by Line
- Equipment and Load Calculations Behind the Upgrade
- Keeping the New Electrical System Trouble-Free
- Sequencing the Electrical Scope Within the Larger Conversion
- Practical Guidance for Homeowners Weighing Options
Why Garage ADUs Almost Always Need Electrical Upgrades
Most detached and attached garages were built with minimal electrical infrastructure, since the original design assumed storage or vehicle parking rather than daily habitation. Once a garage is reclassified as an accessory dwelling unit, it must meet the same electrical demand standards as any other dwelling, which almost never aligns with what already exists. This mismatch is the single most common reason the subpanel upgrade cost garage ADU question comes up early in a project, often during the initial design consultation rather than after permits are pulled.
Assessing the Existing Garage Circuit
A licensed electrician typically begins by tracing the garage's existing circuit back to the main panel to determine available capacity. In older South Bay homes, particularly those built before 1980, the main panel itself may already be near capacity from decades of incremental additions such as central air conditioning or an EV charger. When the main panel has no spare breaker slots or amperage headroom, a dedicated subpanel becomes the only practical path forward, since running everything through the existing panel is not code-compliant or safe.
Code Requirements Driving the Upgrade
California building departments require dwelling units to meet minimum branch circuit counts for lighting, small appliances, laundry (where applicable), and dedicated equipment such as water heaters or HVAC condensers. Readers evaluating how many electrical circuits a garage ADU needs will notice that the circuit count alone often exceeds what a single shared breaker could support, making a subpanel functionally unavoidable in most layouts larger than a small studio.
Pro insight: Request the electrician's load calculation before finalizing the floor plan, since kitchen placement can shift subpanel sizing by several thousand watts.

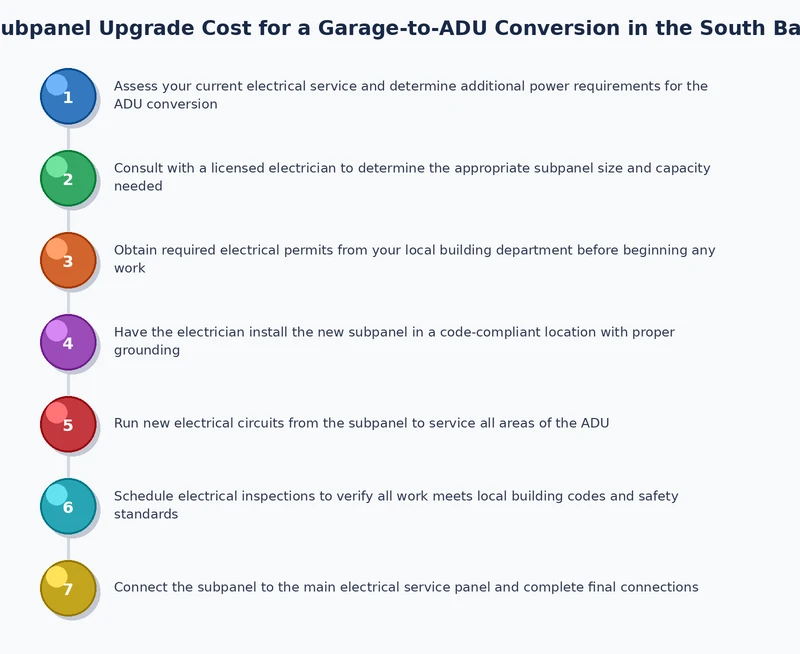

Subpanel Upgrade Cost for a Garage ADU, Line by Line
Pricing for a garage ADU subpanel is rarely a single flat number, since it depends on distance from the main service, trenching needs, and whether the main panel itself requires a simultaneous upgrade to 200 amps. Homeowners comparing this line item against the overall project should reference a detailed breakdown of what it costs to convert a garage into an ADU in San Jose, where electrical work is presented alongside plumbing, framing, and finish costs for full context.
Labor, Materials, and Permit Fees
A straightforward 100-amp subpanel installed close to the main service, with minimal trenching, generally falls at the lower end of the range. Longer conduit runs, especially for detached garages set back from the main house, add both material and labor hours, while permit and inspection fees vary modestly by jurisdiction but rarely exceed a few hundred dollars.

| Subpanel Configuration | Typical Amperage | Estimated Cost Range |
|---|---|---|
| Attached garage, short run | 100A | $2,200 – $3,400 |
| Attached garage, longer run | 100A – 125A | $3,200 – $4,300 |
| Detached garage, trenched conduit | 100A – 200A | $4,000 – $6,500 |
| Main panel upgrade included | 200A | $5,500 – $8,000 |
Regional Pricing Differences Across the South Bay
Labor rates in San Jose, Campbell, and Los Gatos tend to run slightly higher than in more outlying South Bay cities, reflecting both demand and permit processing complexity. Detached structures, which are also governed by setback requirements across South Bay cities, frequently require longer trenched conduit runs to reach the main service, which shifts the estimate toward the higher end of typical ranges regardless of city.
Equipment and Load Calculations Behind the Upgrade
The physical equipment involved in a garage ADU subpanel is not exotic, but correct sizing depends on a defensible load calculation rather than a rough estimate. Contractors typically use a combination of a rated panel enclosure, appropriately gauged feeder wire, and a main breaker sized to match anticipated peak demand.
Panel Sizing and Amperage Selection
Most garage ADUs are adequately served by a 100-amp subpanel, though larger units with electric ranges, tankless water heaters, or heat pump systems may warrant 125 amps or more. Oversizing slightly during initial installation is generally cheaper than a second upgrade later, particularly once drywall and finishes are in place.
Running an Accurate Load Calculation
The National Electrical Code's standard load calculation method, referenced by the National Electrical Code, accounts for general lighting, small appliance circuits, and fixed equipment such as HVAC condensers. This calculation, rather than guesswork, ultimately determines the true subpanel upgrade cost for a garage ADU, since undersized service almost always requires costly rework during final inspection.
Keeping the New Electrical System Trouble-Free
Once installed, a garage ADU subpanel generally requires little ongoing attention, though a few habits extend its service life and keep it compliant through future changes. Documentation matters as much as the physical hardware, since inspectors and future buyers alike will want a clear record of what was installed and why.
Inspection Checkpoints and Documentation
Rough-in and final electrical inspections confirm that breaker sizing, wire gauge, and grounding match the approved plans, and homeowners should retain copies of the panel schedule and permit card indefinitely. This record becomes especially valuable if a future owner or appraiser questions whether the ADU's electrical system was permitted and inspected properly.
Future-Proofing Against Added Appliances
Leaving one or two open breaker slots during installation, even at modest additional cost, accommodates future additions such as a mini-split system or an EV charger without forcing another panel swap. Planning spare capacity upfront is consistently cheaper than retrofitting it after walls are closed.
Warning: Skipping spare capacity to save a small amount upfront often costs several times more once trenching and drywall must be reopened for a second upgrade.
Sequencing the Electrical Scope Within the Larger Conversion
Electrical work does not happen in isolation, and its timing relative to plumbing, framing, and HVAC rough-in has real consequences for both schedule and budget. Coordinating trades early avoids the change orders that tend to inflate overall conversion costs, a pattern also visible in comparable projects such as a garage-to-in-law-suite conversion, where multiple trades overlap in a compressed footprint.
Where the Subpanel Fits in the Construction Timeline
Subpanel installation generally occurs during rough-in, after framing is complete but before insulation and drywall close up the walls. Scheduling it too late in the process risks conflicts with plumbing runs or HVAC ductwork that may already occupy the same wall cavities.
Coordinating With Plumbing and HVAC Rough-In
Because kitchens and bathrooms both draw significant electrical load, plumbing fixture placement should be finalized before the subpanel's circuit schedule is locked in. Detached garage projects, which often carry higher overall conversion costs than attached ones, benefit especially from early coordination since utility trenching serves multiple trades simultaneously.
Practical Guidance for Homeowners Weighing Options
For homeowners still deciding whether a full ADU conversion makes sense, understanding the electrical scope early helps set realistic expectations before design commitments are finalized. A few practical steps consistently reduce surprises later in the process.
Permit Pitfalls Worth Avoiding
Homeowners sometimes assume that lighter-scope projects, such as a garage home office conversion, avoid electrical permitting entirely, but any added circuit or panel work still requires inspection. Skipping this step, even for modest projects, creates complications during resale when disclosure forms ask about permitted work.
- Confirm main panel capacity before finalizing appliance selections
- Request a written load calculation, not a verbal estimate
- Ask whether trenching costs are included in the subpanel quote
Selecting a Contractor Familiar With Local Requirements
Working with a contractor who regularly pulls permits in the specific South Bay city where the project is located reduces back-and-forth with plan checkers. Familiarity with local variations, including how different jurisdictions interpret Title 24 energy provisions, tends to shorten approval timelines considerably.
Frequently Asked Questions
Does every garage ADU conversion require a subpanel?
Not universally, but most conversions need one once kitchen, bathroom, and HVAC loads are added to a circuit originally designed for basic garage use.
What is the average subpanel upgrade cost for a garage ADU in the South Bay?
Most projects fall between $2,200 and $6,500, depending on amperage, distance from the main panel, and whether trenching is required.
Can the existing garage circuit be reused instead of adding a subpanel?
Rarely, since existing circuits are typically undersized for the combined lighting, appliance, and mechanical loads a dwelling unit requires.
Does a detached garage cost more to upgrade electrically than an attached one?
Generally yes, since detached structures often require trenched conduit runs that add both material and labor costs.
Is a permit required for a subpanel installation?
Yes, electrical permits and inspections are required regardless of whether the surrounding conversion is a full ADU or a smaller-scope project.
Should the subpanel be sized larger than current needs?
Adding modest spare capacity during initial installation is generally more economical than retrofitting additional capacity later.
When during construction should the subpanel be installed?
Typically during rough-in, after framing but before insulation and drywall, to allow coordination with plumbing and HVAC trades.
Final Thoughts
Budgeting accurately for a garage ADU conversion means treating the subpanel upgrade as a core line item rather than an afterthought discovered mid-permit. Homeowners ready to move forward should request a written load calculation and subpanel quote alongside their overall project estimate before finalizing any design decisions.
