What actually stands between a Campbell homeowner and a legal, rentable ADU sitting in what used to be a garage? Mostly paperwork — but the right paperwork, filed in the right order. The campbell garage to adu permit process runs through Building, Planning, and often Santa Clara County Fire before a single stud gets nailed, and homeowners who understand that sequence up front save themselves months of back-and-forth. This guide walks through exactly how that sequence works, from pre-application research to final inspection, and flags the places where most projects stall. For a broader look at how conversion scope affects cost and design decisions, the garage-to-ADU conversion service page breaks down what's typically included in a full build.

Campbell garage to ADU permit process paperwork and building plans on a table
Figure 1 — Reviewing permit documents before submitting a Campbell garage conversion application.

Campbell processes ADU applications under the same statewide streamlining rules that apply across California, but the city layers on its own submittal checklist, plan check turnaround times, and inspection sequencing. Most delays trace back to incomplete submittals rather than actual disapprovals — missing Title 24 documentation, unclear utility separation plans, or site plans that don't match the county assessor's parcel map. Getting these right the first time is the single biggest lever homeowners have over their own timeline.

Where the Campbell Garage to ADU Permit Process Fits Into State Law

California's ADU statutes set the floor; Campbell's municipal code fills in the local details on top of it. Anyone researching the campbell garage to adu permit process should understand both layers, because the state rules limit what the city can require, while the local checklist determines what actually gets submitted.

State Streamlining vs Local Review

  • State law caps ministerial ADU review at 60 days from a complete application — no discretionary hearings, no design review board.
  • Garage conversions specifically qualify for expedited processing since they don't expand the building footprint.
  • Campbell still runs its own plan check for structural, electrical, plumbing, and mechanical compliance — that part isn't optional or skippable.
  • The 60-day clock only starts once the application is deemed complete, which is exactly where incomplete submittals cost the most time.
Pro tip: submit a complete package the first time. An incomplete application doesn't just pause the clock — it resets it once resubmitted, which is the single most common source of avoidable delay.

Which Departments Touch the Application

  1. Building Division — structural, electrical, plumbing, mechanical plan check and inspections.
  2. Planning Division — setbacks, lot coverage, and confirming the conversion doesn't trigger a discretionary review.
  3. Santa Clara County Fire — access and, in some cases, sprinkler requirements depending on total square footage on the lot.
  4. Utility providers — separate metering decisions, which affect both the plan set and the timeline.

For background on how the U.S. Department of Housing and Urban Development frames accessory dwelling units as part of the broader housing supply conversation, see the HUD ADU policy brief — useful context for why states like California pushed streamlining rules in the first place.

Simple Garage Refresh vs Full ADU Conversion

Not every garage project needs the same permit path. Scope determines which boxes get checked on the Campbell submittal form, and homeowners frequently over-scope or under-scope their first application.

JADU-Level Scope

  • Attached garage, shared entrance or interior connection to the main house permitted.
  • Efficiency kitchen allowed instead of a full kitchen — smaller footprint, fewer plumbing runs.
  • Owner-occupancy rules may apply depending on how the unit is used; this differs by jurisdiction, so don't assume San Jose's rules carry over one-to-one — Campbell has its own version worth confirming before design starts.
  • Typically the fastest permit path because the structural scope stays minimal.

Full ADU Scope

  • Independent living unit with full kitchen, bathroom, and separate entrance.
  • Requires its own utility connections or a clearly documented sub-metering plan.
  • Detached garages converted to full ADUs face additional foundation and fire-separation scrutiny — the detached garage ADU comparison covers how that scope stacks up against building new from scratch.
  • Parking replacement rules kick in more often at this scope than at the JADU level.

Homeowners weighing natural light upgrades as part of a full conversion should also budget time for that scope decision early — window or skylight changes affect the plan set and, in some cases, Title 24 calculations. The natural light options guide lays out the tradeoffs between the two approaches.

StageTypical DurationWhat Happens
Pre-application research1–2 weeksZoning check, utility capacity, scope decision
Plan set preparation2–6 weeksArchitectural, structural, Title 24 documents assembled
Application intakeSame dayCompleteness screening at submittal counter
Plan check reviewUp to 60 daysBuilding, Planning, and Fire review run concurrently
Corrections (if any)1–3 weeks per roundResubmittal addressing plan check comments
Permit issuanceSame day once approvedFees paid, permit issued, construction can begin
Construction & inspectionsVaries by scopeRough-in, framing, and final inspections scheduled per phase

Submittal Mistakes That Stall Plan Check

Most delays in the campbell garage to adu permit process aren't caused by disapproval — they're caused by avoidable gaps in the initial package. A few patterns show up again and again.

Incomplete Documentation

  • Missing or mismatched Title 24 energy compliance forms — these need to match the actual plan set, not a generic template.
  • Site plans that don't reflect current setback measurements; the Santa Clara setback guide covers the requirements homeowners most often overlook.
  • Structural calculations omitted for conversions that alter roof framing or remove a garage door header without a proper beam replacement.
  • No fire-rated wall detail specified where the conversion shares a wall with the main structure.
Warning: submitting a plan set without a signed structural calc for header removal is one of the fastest ways to draw a correction letter — plan check reviewers flag it almost every time.

Utility Assumptions

  1. Assuming the existing electrical panel has enough capacity without running a load calculation first.
  2. Skipping the sewer lateral capacity check before committing to a full bathroom layout.
  3. Failing to document backwater valve requirements when the conversion adds a bathroom below the street sewer elevation — a detail that trips up more Campbell projects than homeowners expect.
  4. Not confirming whether GFCI/AFCI circuit requirements were baked into the electrical plan from the start.

Bathroom additions carry their own plumbing scrutiny regardless of city. The backwater valve guide explains when that fixture becomes mandatory rather than optional.

Moving Through Plan Check and Inspections Faster

Speed in the campbell garage to adu permit process comes down to preparation, not luck. A few habits consistently shave weeks off the timeline.

Pre-Application Legwork

  • Pull the parcel's zoning designation and confirm lot coverage math before paying an architect for a full plan set.
  • Request a utility capacity letter early if the project depends on panel upgrades or new gas service.
  • Have an electrician assess panel headroom before committing to a full-kitchen layout — undersized service is one of the most common late-stage redesigns.
  • Confirm whether the lot's existing structures already meet parking requirements, since that answer shapes the whole site plan.

Scheduling Inspections Strategically

  1. Group rough-in inspections — electrical, plumbing, and mechanical — on the same visit whenever the inspector's schedule allows it.
  2. Don't close up walls until framing and rough electrical both pass; reopening drywall for a missed inspection is one of the most expensive scheduling mistakes on a conversion.
  3. Keep the Title 24 compliance documents on-site for the final inspection — inspectors ask for them more often than homeowners expect.
  4. Book final inspections early in the week; late-week slots fill fastest and push stragglers into the following week.
Insider tip: inspectors move faster through a job site that's staged cleanly — panel schedule posted, access panels unobstructed, and permit card visible. It's a small thing that consistently speeds up the visit.

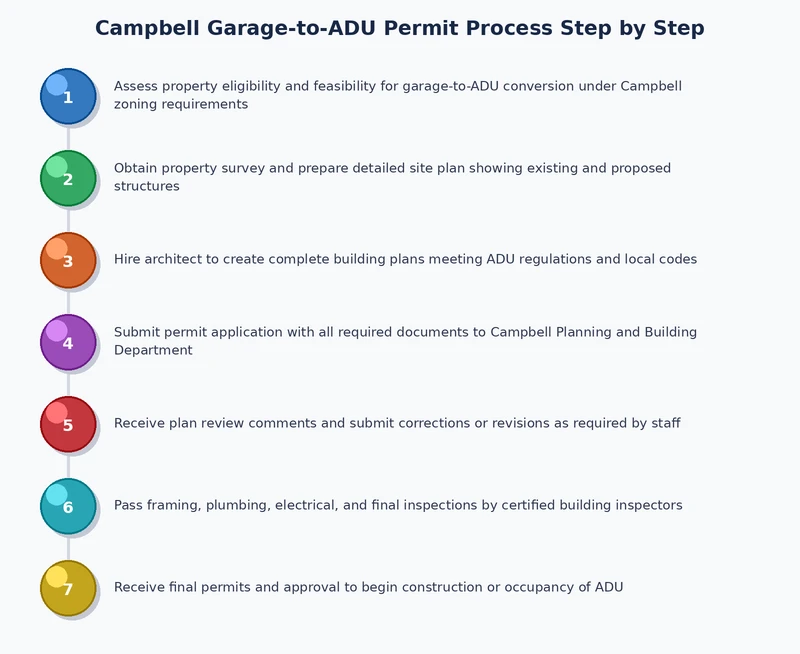

Diagram of the Campbell garage to ADU permit process from application to final inspection
Figure 2 — The Campbell garage-to-ADU permit process from pre-application through final inspection.

Myths About Campbell ADU Permits

A handful of persistent myths cause homeowners to either delay projects unnecessarily or walk into plan check unprepared.

"Approval Takes Months No Matter What"

  • State law caps ministerial review at 60 days for complete applications — that's a ceiling, not an average.
  • Well-prepared submittals with no corrections routinely clear plan check faster than the full 60-day window.
  • The variable isn't the city's speed; it's how complete the initial package is.

"A New Parking Spot Is Always Required"

  • Garage conversions are frequently exempt from replacement parking requirements under state ADU law, particularly for JADUs.
  • Proximity to transit can further reduce or eliminate parking obligations depending on the parcel's location.
  • Homeowners should verify this parcel-by-parcel rather than assuming either outcome — the answer genuinely varies.

According to Wikipedia's overview of secondary suites, parking exemptions for accessory units have become increasingly common across U.S. jurisdictions as cities pursue infill housing — Campbell's rules reflect that broader trend rather than standing apart from it.

Staying Compliant After Final Sign-Off

The campbell garage to adu permit process doesn't end at final inspection. A few ongoing habits keep the unit legally compliant and protect its value long-term.

Recordkeeping

  • Keep copies of the approved plan set, Title 24 forms, and final inspection sign-off — future refinancing or resale almost always asks for them.
  • Note any occupancy restrictions tied to owner-occupancy requirements, especially for JADU-scope conversions.
  • Retain contractor invoices for major systems — panel upgrades, sewer work, structural changes — in case warranty claims come up later.

Handling Future Changes

  1. Any future modification — adding a window, changing a wall, upgrading electrical — needs its own permit; the original ADU approval doesn't cover later work.
  2. Re-verify Title 24 compliance if HVAC or insulation gets touched during a future remodel.
  3. Check with Planning before converting the unit's use again — a JADU upgraded later to a full ADU triggers a fresh review.

Frequently Asked Questions

How long does the campbell garage to adu permit process typically take?

Complete applications are capped at 60 days for ministerial review under state law, though well-prepared submittals with no correction rounds often clear faster.

Does converting an attached garage require a full ADU permit or a JADU permit?

It depends on scope. Shared-entrance conversions with an efficiency kitchen generally qualify as JADUs, while independent units with a full kitchen and separate entrance fall under full ADU rules.

Is a new parking space required for a garage conversion in Campbell?

Not always. Many garage conversions are exempt from replacement parking under state ADU law, particularly JADUs and units near transit, but this should be confirmed for the specific parcel.

What causes the most delays in Campbell's plan check process?

Incomplete documentation is the leading cause — missing Title 24 forms, mismatched site plans, and absent structural calculations for header removal all trigger correction letters that reset review time.

Does a garage-to-ADU bathroom always need a backwater valve?

Only when the new fixtures sit below the street sewer elevation. It's not universal, but it's common enough in garage conversions that it should be checked early in design.

Can construction start before the permit is issued?

No. Permits must be issued before any construction begins; starting early risks stop-work orders and can complicate final approval.

Do future renovations to the ADU require new permits?

Yes. The original approval only covers the scope of work reviewed at the time — later changes to walls, windows, or major systems need their own permit.

Next Steps

  1. Pull the parcel's zoning and setback information before committing to a design or hiring an architect.
  2. Get an electrical load calculation done to confirm whether the existing panel supports the planned scope.
  3. Decide between JADU and full ADU scope early, since it changes the plan set, fees, and review path.
  4. Assemble a complete submittal package — Title 24 forms, structural calcs, and site plan — before scheduling the intake appointment.
  5. Line up a licensed contractor who has handled Campbell ADU permits before to avoid avoidable correction rounds.
