California's Title 24 energy code has been tightened so many times since it first launched that a garage conversion permitted just five years ago can already fall short of today's standards, which is exactly why a title 24 energy compliance garage conversion checklist belongs at the top of your planning binder before you touch a stud. Whether you're turning a two-car garage into a JADU, a home office, or a full in-law suite, the energy compliance review is one of the most common points where South Bay homeowners get stuck waiting on plan check. You don't need to become an energy consultant to get through it, but you do need to understand what the city is actually checking for and why.
Think of Title 24 Part 6 as the state's way of making sure every converted garage performs close to how a newly built room would, even though you're working inside an old shell that was never designed to be heated or cooled. Your city's plan checker will use a version of the same checklist reviewers rely on statewide, and if you show up prepared with your own copy, you'll move through the review a lot faster. Related decisions, like whether you're pursuing a JADU or a full ADU conversion, also shape which compliance path applies to your project, so it helps to settle that question early.
This guide walks through the full title 24 energy compliance garage conversion checklist in the order most South Bay building departments review it, from insulation and windows to HVAC sizing and the paperwork your energy consultant will eventually stamp. You'll also see where homeowners typically trip up and how to keep your conversion compliant well after the final inspection is signed off.
Contents
Understanding What Title 24 Actually Reviews
Before you can build a useful title 24 energy compliance garage conversion checklist, you need to understand what the code is actually measuring, because it isn't a simple pass-or-fail list of materials. Title 24 Part 6 uses a performance-based approach that compares your proposed conversion against a standard reference design with similar square footage and orientation. Your converted space has to perform at least as well as that reference building across heating, cooling, water heating, and lighting energy use combined.
The Building Envelope Standards
The envelope is where most of the compliance work happens in a garage conversion, since you're essentially building an insulated, conditioned room inside a shell designed for parking cars. You'll need continuous insulation in the walls, ceiling, and often the slab edge, along with windows and doors that meet minimum U-factor and solar heat gain coefficient ratings. If you're leaning toward a home office rather than a full living unit, the Title 24 insulation requirements for garage office conversions spell out the exact assemblies that typically satisfy your local jurisdiction.
Pro tip: order your insulation and window specs before framing starts, not after — swapping materials mid-build almost always triggers a plan check resubmittal.
Mechanical and Lighting Requirements
Your HVAC system, water heating equipment, and lighting fixtures all factor into the same energy budget as your walls and windows, which means an oversized furnace can sometimes offset gains you made elsewhere in the envelope. Most conversions now require high-efficacy LED lighting throughout, along with ducts that are sealed and tested if any portion runs through unconditioned space like an attic. You'll also want to confirm your electrical panel can support the added mechanical load, since how many electrical circuits your garage ADU needs often depends directly on the HVAC and appliance choices you make here.

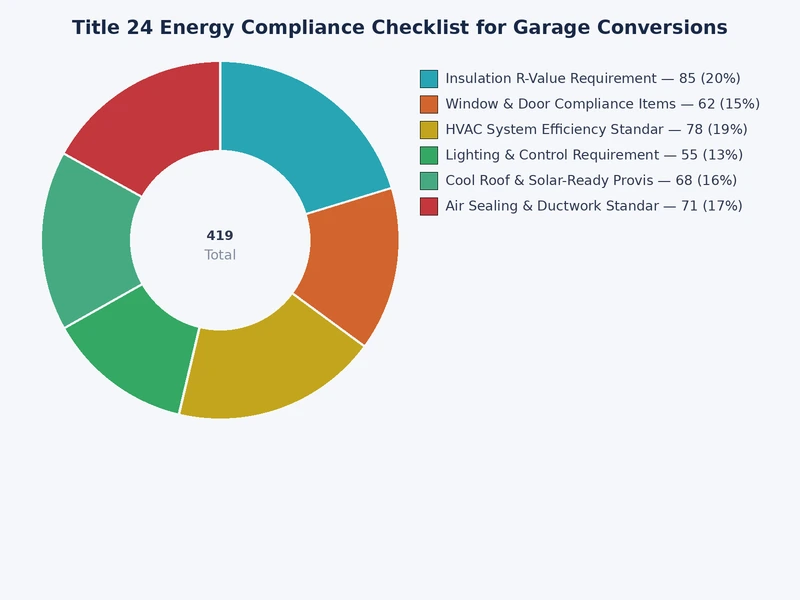

Building Your Compliance Checklist Step by Step
Once you understand the categories Title 24 reviews, assembling your own checklist becomes a matter of gathering the right documentation in the right order rather than guessing what a plan checker wants to see. Most South Bay building departments expect a consistent package, and having it organized in advance genuinely speeds up your review timeline.
Documentation You'll Need Ready
Start by pulling together your floor plans, elevations, and a written scope of work that clearly states you're converting an existing garage rather than building new square footage, since that distinction affects which compliance path applies. You'll also want your window and door schedule with manufacturer performance ratings, your insulation R-value assignments for every assembly, and your proposed HVAC equipment specifications. A rough checklist typically includes:
- Existing and proposed floor plans with conditioned square footage clearly labeled
- Insulation R-values for walls, ceiling, and slab or subfloor assemblies
- Window and door U-factor and SHGC ratings from the manufacturer
- HVAC equipment cut sheets, including efficiency ratings and duct routing
- Lighting fixture schedule confirming high-efficacy compliance
Compliance Forms and Software Reports
Your energy consultant will run your project through approved compliance software, usually CBECC-Res, to generate the CF1R Certificate of Compliance that gets submitted alongside your building permit application. This is also the point where your San Jose ADU garage conversion permit requirements and your Title 24 documentation start to overlap, since the building department reviews both packages together before issuing your permit. Later, during construction, inspectors will collect a CF2R installation certificate and a CF3R verification form for anything requiring field testing.
| Checklist Item | Typical Requirement | Verified By |
|---|---|---|
| Wall insulation | R-13 to R-19 cavity, depending on assembly | Plan check + field inspection |
| Ceiling insulation | R-30 to R-38 | Plan check + field inspection |
| Window U-factor | 0.30 or lower, climate zone dependent | NFRC label + CF1R |
| Duct sealing | Required if ducts run outside conditioned space | HERS rater (CF3R) |
| Lighting | 100% high-efficacy fixtures | CF2R installation certificate |
Common Mistakes That Slow Down Approval
Even homeowners who start with good intentions run into the same handful of errors over and over, and most of them are avoidable if you know where they tend to occur. Recognizing these ahead of time can save you weeks of resubmittals and change orders once framing has already started.
Underestimating the Envelope Upgrade
Garages are notorious for having minimal or no insulation in the original construction, and homeowners frequently assume that adding a modest layer of batt insulation will be enough to satisfy Title 24. In reality, your consultant may need to model a higher-performance assembly, better windows, or additional air sealing to hit the required energy budget, especially if your garage has large uninsulated slab areas. Setback and space constraints matter here too, and reviewing your San Jose in-law suite setback requirements early can prevent design conflicts that force you to redo envelope calculations later.
Common mistake: assuming your existing garage slab doesn't need edge insulation just because it's already poured — most jurisdictions still require it for conditioned space.
Mismatched HVAC Sizing
Contractors sometimes default to whatever mini-split or furnace size they have on hand rather than running a proper load calculation for the newly conditioned space, and an oversized or undersized unit can throw off your entire compliance report. You'll get better results, and often a smoother inspection, if your HVAC contractor performs a Manual J load calculation before equipment is ordered rather than after. This is also a good moment to double check your subpanel upgrade cost for a garage-to-ADU conversion, since undersized electrical capacity is a frequent side effect of last-minute HVAC changes.
Real-World Examples from South Bay Conversions
Seeing how these requirements play out on actual projects tends to make the checklist feel less abstract, so here are two representative examples from recent South Bay garage conversions.
An Attached Garage-to-JADU Project
On a typical attached garage-to-JADU conversion, the biggest compliance hurdle was usually the shared wall with the main house, since that wall needed continuous insulation and an air barrier even though it technically sat inside the existing building footprint. Homeowners in this situation often benefit from reviewing the California Energy Commission's public guidance on residential compliance before their consultant runs the final model, so they understand which assumptions are driving their numbers. You can find the state's official building energy efficiency standards resources directly from the California Energy Commission if you want to dig into the source documents yourself.
A Detached Garage Office Build
A detached garage converted into a home office presented a different challenge, since the structure sat further from existing utility connections and needed its own compliant HVAC system rather than an extension of the main house's ductwork. In cases like this, energy modeling software often shows that upgrading the roof insulation delivers a bigger compliance return than spending extra on premium windows, which is worth discussing with your consultant before finalizing your materials budget.
Warning: don't assume a detached structure automatically qualifies for a simpler compliance path — standalone conditioned buildings sometimes face stricter envelope requirements, not looser ones.
Keeping Your Conversion Compliant Long-Term
Passing your final inspection isn't the end of the story, because the energy performance you built into your garage conversion needs to hold up over years of normal use and eventual upgrades.
Maintaining Envelope Performance
Insulation can settle, weatherstripping around doors and windows can degrade, and duct sealing can loosen over time, all of which gradually erode the energy performance your compliance report assumed on day one. A simple annual check of weatherstripping, caulking, and visible insulation gaps will help your conversion keep performing the way it was designed to, and it's a lot cheaper than discovering a problem during a future remodel permit.
Planning for Future Upgrades
If you ever plan to add square footage, swap your HVAC system, or convert your JADU into something larger down the road, keep your original CF1R, CF2R, and CF3R paperwork on file, since future permits will likely reference your existing compliance baseline. This is especially relevant if you're still weighing which permit path fits your JADU or ADU garage conversion in San Jose, because the energy documentation from your first phase can carry forward and simplify later approvals. Keeping a digital folder of every compliance form makes future conversations with contractors and inspectors far more efficient than starting from scratch.
Frequently Asked Questions
Does every garage conversion need a Title 24 energy compliance review?
Yes, any garage converted into conditioned living or working space in California needs to demonstrate compliance with Title 24 Part 6, regardless of whether it becomes a JADU, ADU, office, or in-law suite.
Who prepares the CF1R Certificate of Compliance?
A licensed energy consultant or HERS rater typically runs your project through approved compliance software and prepares the CF1R, which then gets submitted with your building permit application.
Can I reuse my garage's existing insulation to save on compliance costs?
It depends on the material and condition, but most garages have minimal or outdated insulation that won't meet current R-value requirements, so a full upgrade is usually necessary.
How long does the Title 24 compliance process add to my permit timeline?
If your documentation is complete and consistent with your building plans, the energy compliance review typically doesn't add significant time beyond your standard permit review.
Do windows and doors need special certification for Title 24?
Yes, windows and doors need NFRC labels showing their U-factor and solar heat gain coefficient so your energy consultant can confirm they meet the performance thresholds used in your compliance model.
Does HVAC duct sealing testing apply to every garage conversion?
Duct sealing verification generally applies whenever ductwork passes through unconditioned space, which is common in garage conversions where equipment sits in an attic or adjacent unconditioned area.
Key Takeaways
- A title 24 energy compliance garage conversion checklist should cover envelope insulation, window ratings, HVAC sizing, and lighting before you finalize your building plans.
- Gathering your CF1R, CF2R, and CF3R documentation early prevents the most common plan check delays homeowners run into.
- Oversized or undersized HVAC equipment and under-insulated slab edges are the two mistakes that most often force a resubmittal.
- Keeping your compliance paperwork on file after final inspection makes any future upgrades or additions significantly easier to permit.
